ARAPUNI DAM ENHANCEMENT PROJECT

The Arapuni Hydro Dam

The Arapuni Hydro Dam is operated by Mercury and forms an essential part of the Waikato Hydro System, which provides about 10% of Aotearoa New Zealand’s electricity. The Arapuni Hydro Dam and nearby Arapuni Hydro Station began operating in 1929. As the first high dam on the Waikato River, it is recognised for its engineering significance and is a listed historic heritage item.
The hydro station’s eight turbines have an installed capacity of 196MW, generating up to 805GWH per year, that’s enough to power about 100,000 average homes with renewable energy.

Explore general information about the Arapuni Hydro Station.

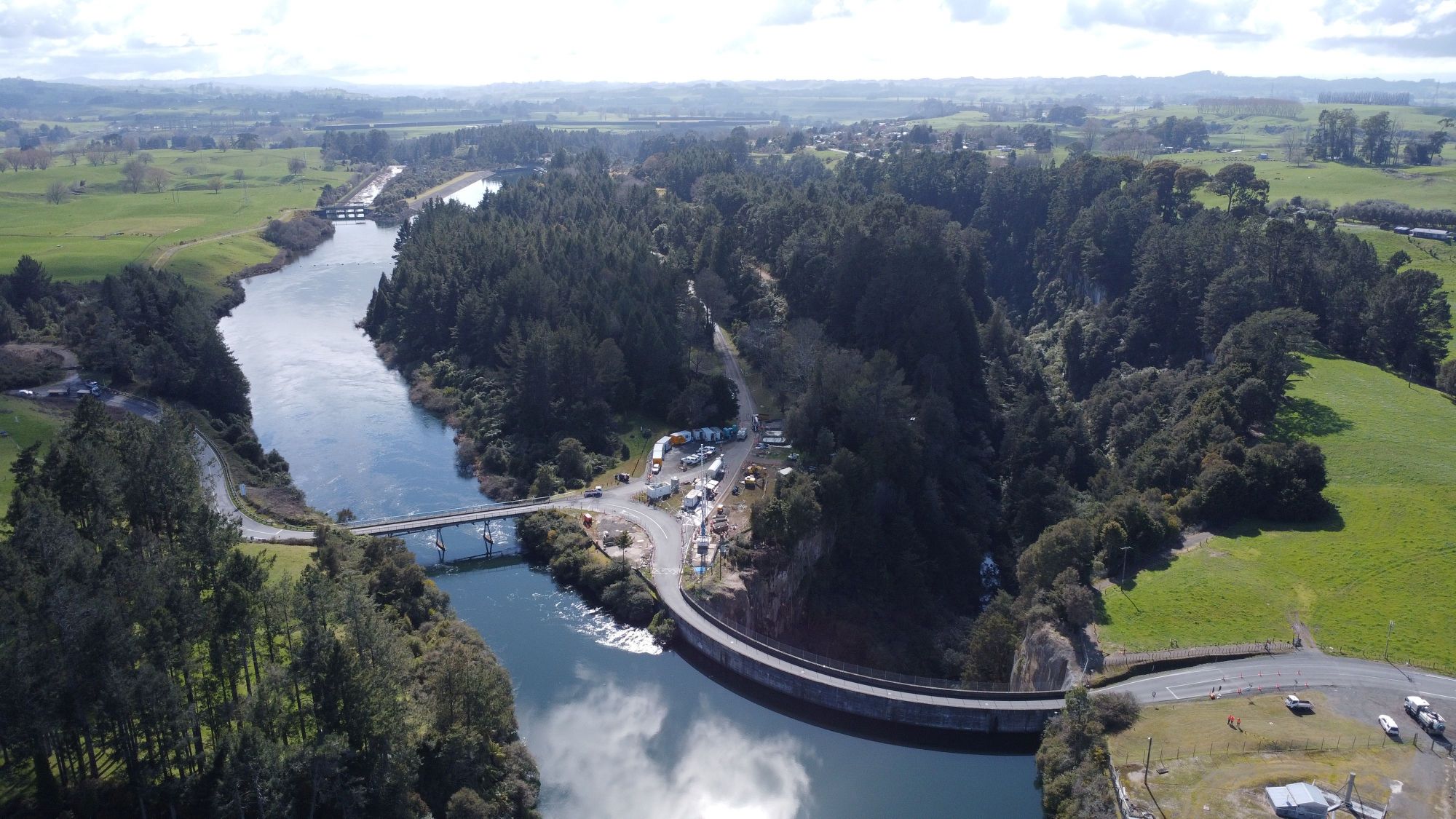

aerial shot of Arapuni dam

The jet grouting trial work site was set up on the left abutment from July-September, at the Arapuni Hydro Dam.

Project overview

An engineering study shows the Arapuni Hydro Dam is safe and fit for everyday use, but work needs to be done to improve the left abutment to protect it from the risk of water seepage. Seepage happens when very small amounts of water soak around the dam abutment. A controlled amount is expected and needs to be managed, but over time too much seepage will result in increased pressures and a risk of internal erosion.

We have assessed options to install a seepage cutoff wall in the left abutment; this is a concrete barrier that prevents seepage. We have also been working on geotechnical assessments which will help inform the work design and construction of the cutoff wall.  

Since mid-2024, we’ve been in discussions with our iwi partners, Raukawa, Ngaati Koroki Kahukura and Ngaati Hauaa, as well as the South Waikato District Council, Waikato Regional Council, Waipā District Council and other key stakeholders to understand the impacts of the work we have planned for the dam. We have kept the community informed as we developed our plans and we will continue to update everyone as the project progresses. 

Download our project explainer.

Project Update1 Vid Tile

Video: Arapuni Project update No. 1

Iwi Video

Video: Working with Iwi

Project background

The Arapuni Dam is the oldest Mercury dam (in operation). It was built between 1924 and 1929 and was the first government-built high dam on the Waikato River.

The dam has had remediation treatment for leakage, dating back to its construction. Following the first lake fill in 1930, significant seepage of water traveling through the left abutment from the headrace to the dam face was observed. The lake was lowered, and seepage controls were retrofitted.

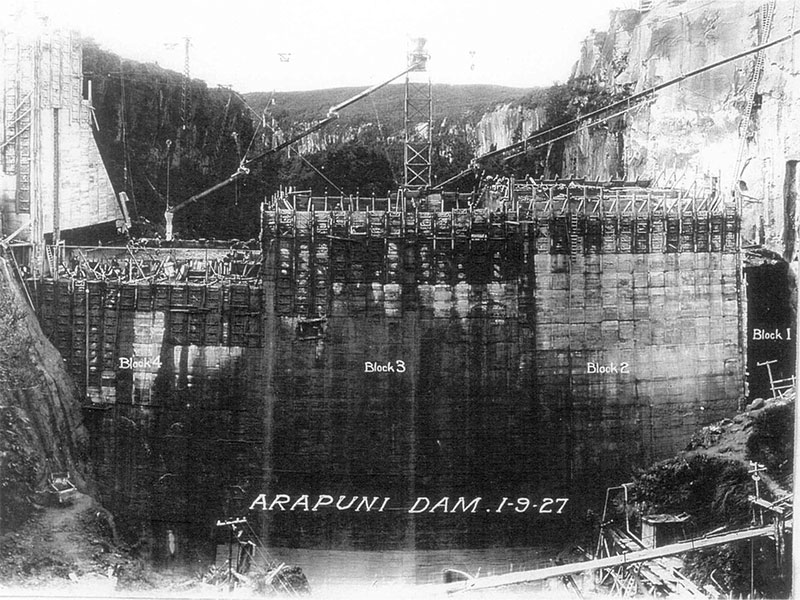

Arapuni Dam in 1927

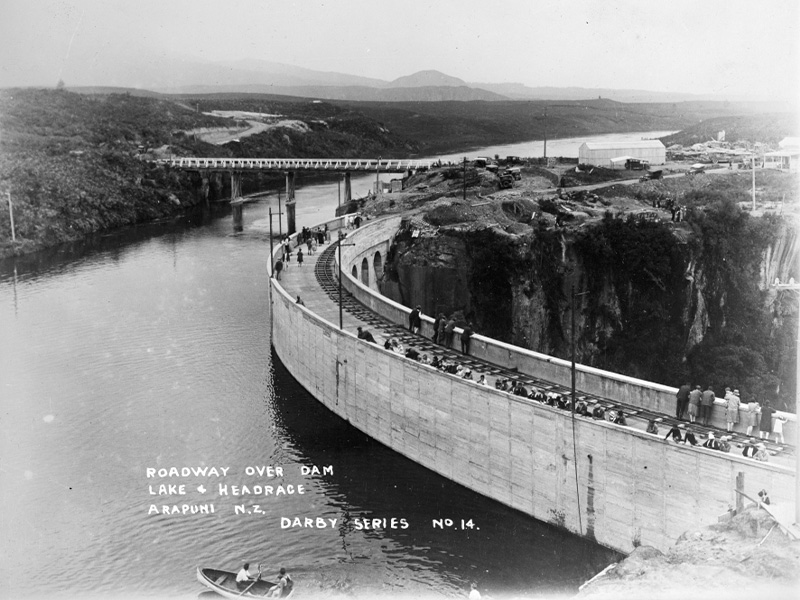

Arapuni Dam 1927 02

The Arapuni Hydro Power Station was constructed between 1924 and 1929.

Aerial view of Arapuni Dam looking north with machinery on the bridge during the mid-2000s works

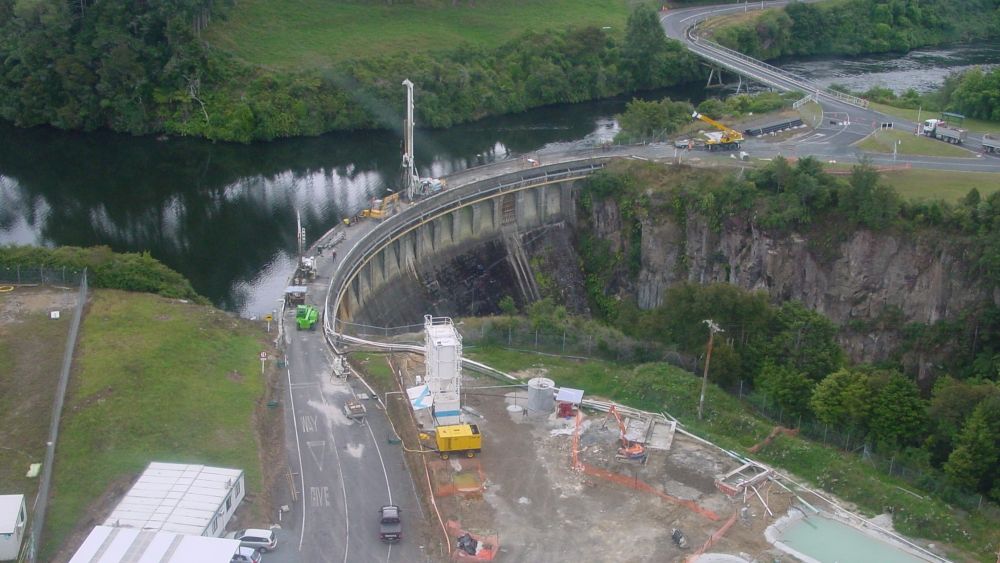

Major remediation work was completed on the dam in the mid-2000s.

Mid-2000s works

Over the life of the dam there have been several improvements made to the seepage controls, with the most recent in mid-2000s.

This involved remediation work to construct a concrete cut-off wall under the dam, without disrupting power generation or causing environmental damage. This was a pioneering effort in the field of dam engineering.

The project won multiple engineering awards, including the Shell Environmental Excellence Merit Award in 2007 and the New Zealand Engineering Excellence Award in 2008. The work was recognised for its innovative approach to dam remediation while maintaining operations and minimising environmental impact.

The project was led by an alliance group comprising Mighty River Power (now Mercury), Brian Perry Civil and Trevi Group, a specialist in underground engineering. The three have reformed to work together on the remediation of the left abutment at the Arapuni Dam.

Aerial view of Arapuni dam looking south with area of the project zone for the left abutment in foreground shaded to illustrate area of work

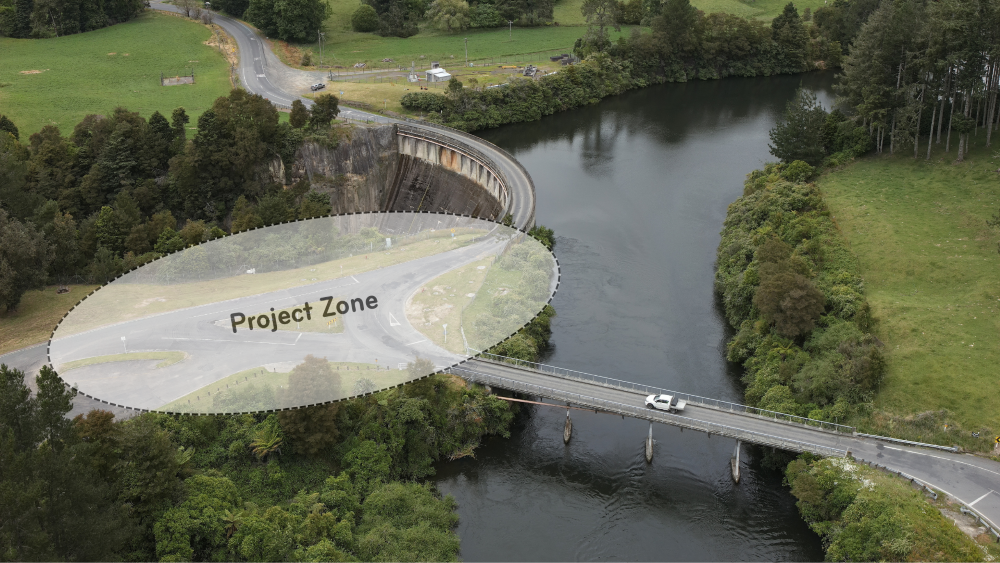

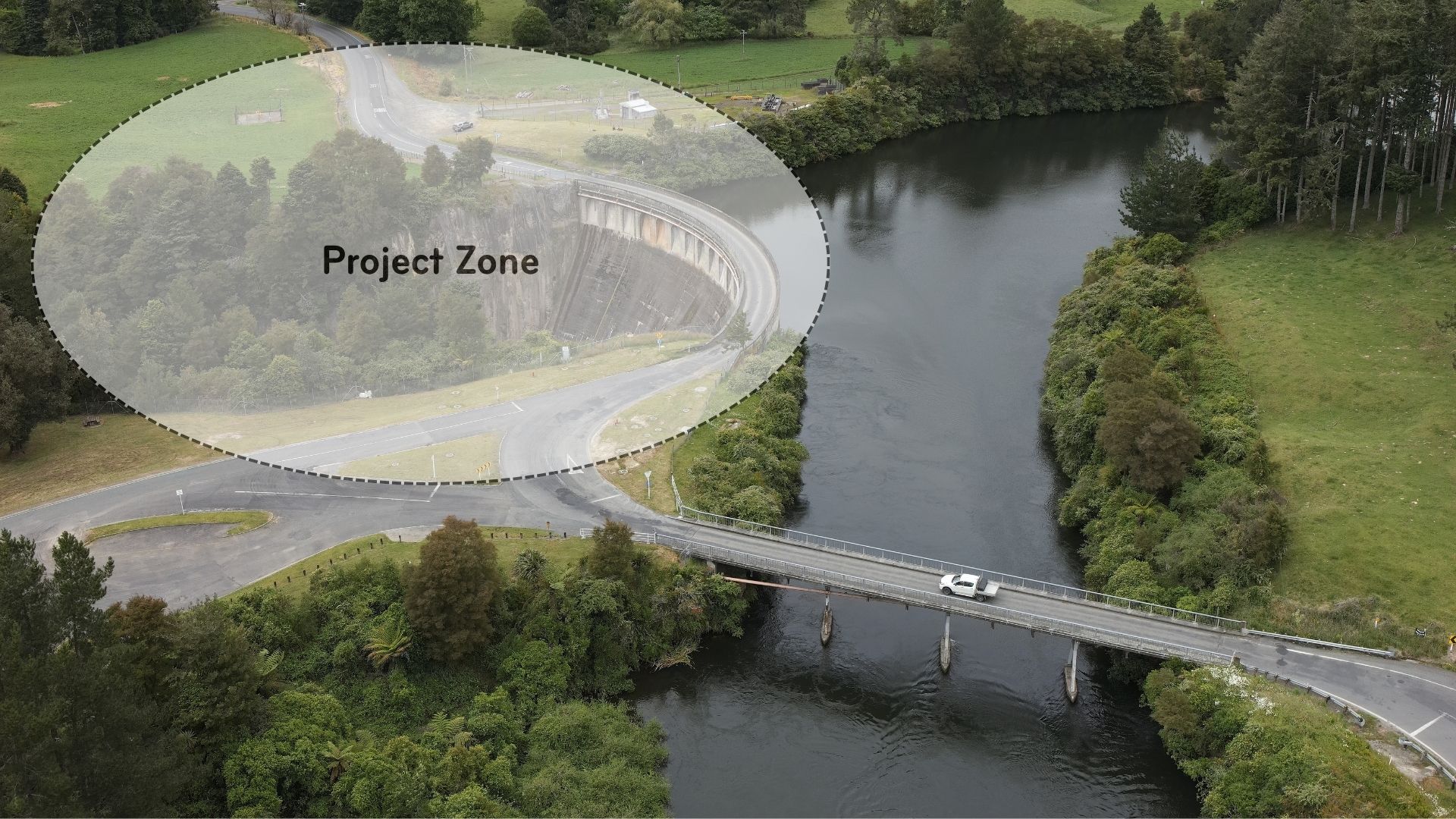

The left abutment of the dam is where our current remediation work will be focused.

Early works, 2024-2025

Ongoing monitoring indicates that the remediation work completed in the mid-2000s was extremely effective. However, seepage changes were identified in the left abutment following two distant earthquakes in 2016.

In 2024, we began investigating options to install a seepage cutoff wall in the left abutment, as a modern equivalent to manage the seepage.

In 2025, we began early  works which involved relocating existing subsurface sensors and installing new ones to help us understand what’s happening in the left abutment. We now have more than 200 subsurface sensors providing real-time data. This information will help us respond to any changes in the left abutment as we carry out the main works programme.

Jet grouting trial

We completed a jet grouting trial from July to September 2025.

This is a soil improvement technique used to strengthen and stabilise the ground. It has been used in several hydro dam remediation projects around the world. During September and October, we studied the results of the trial which helped inform and plan the main works for 2026.

Download our info sheet on jet grouting.

Relief drainage

We started a relief drainage programme in January 2026 and will complete it by July 2026.

Hydro dams hold back large volumes of water, which exerts significant pressure on the dam structure and the surrounding geology. Relief drainage is used to help reduce pore water pressure in the dam foundation and abutments and prevent uplift pressure that could destabilise the dam base.

Watch our video on the relief drainage programme.

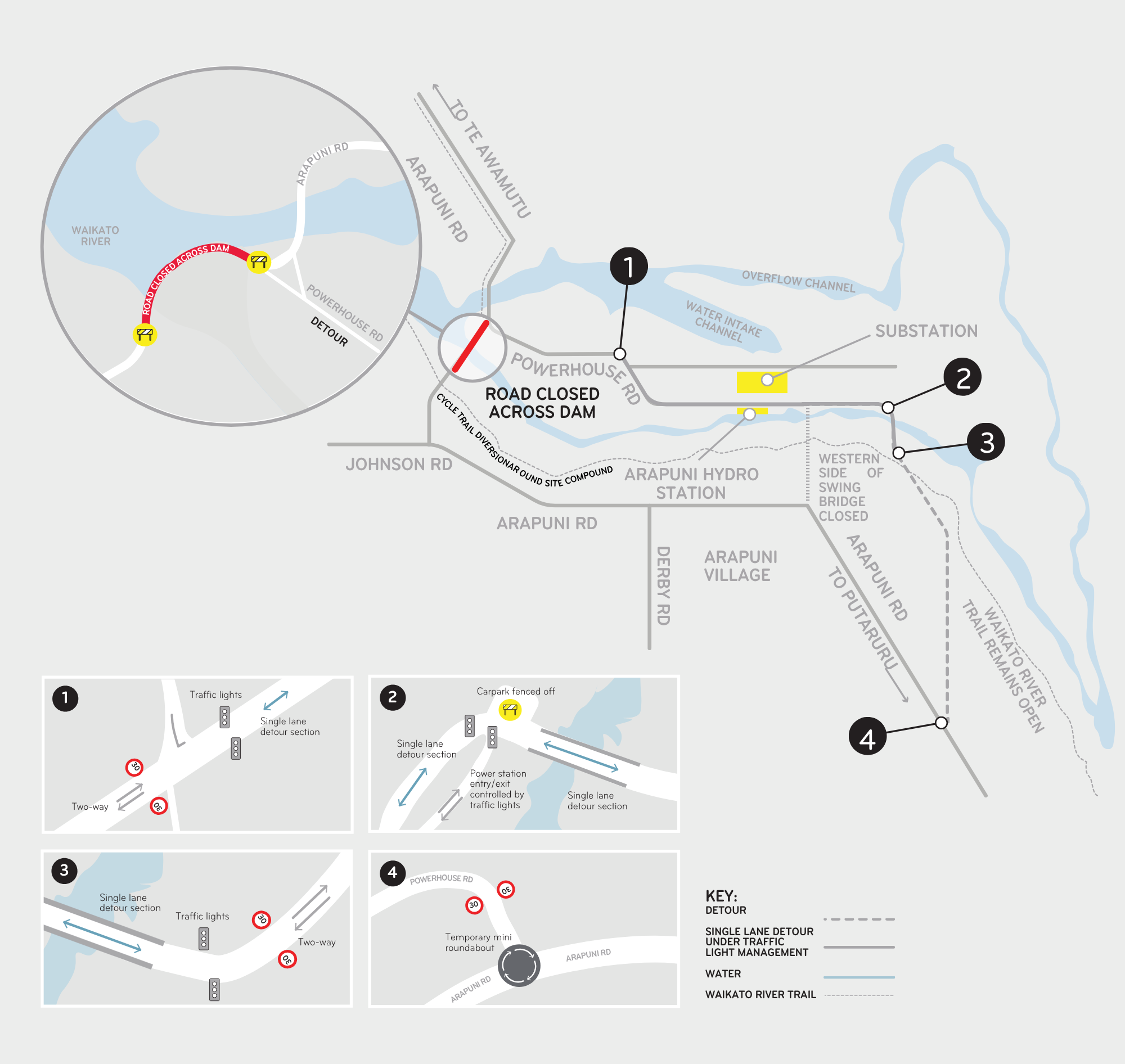

Detour route

Arapuni Road across the dam will be closed to vehicles from July 2026, for 24-36 months.
We will use a one-lane detour route, managed by traffic lights, along Powerhouse Road for local essential traffic only.

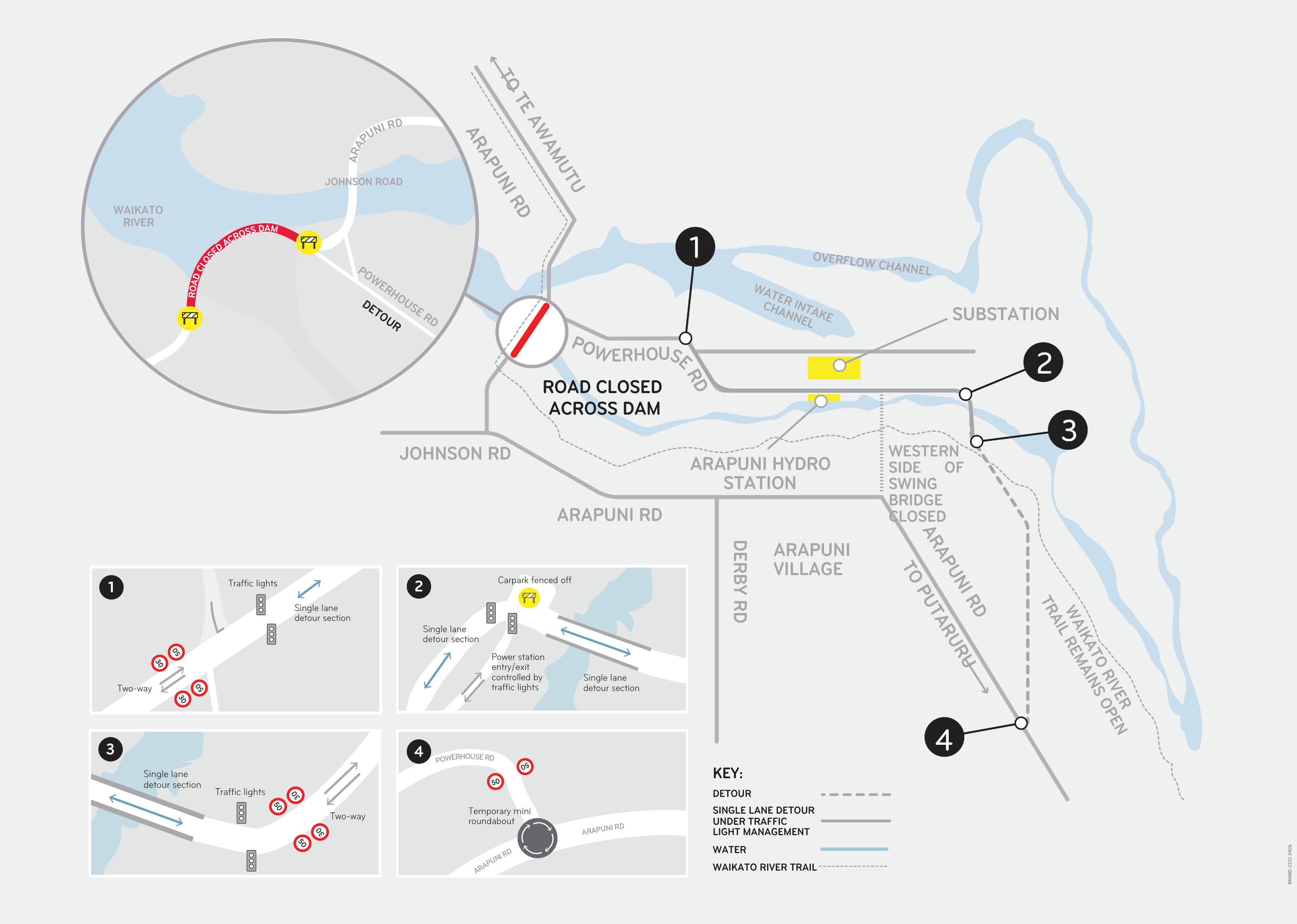

map of Powerhouse Road detour route

Download the Powerhouse Road detour route map for essential travel (PDF)

Freight/heavy commercial vehicles and long-distance travel should use state highway routes.

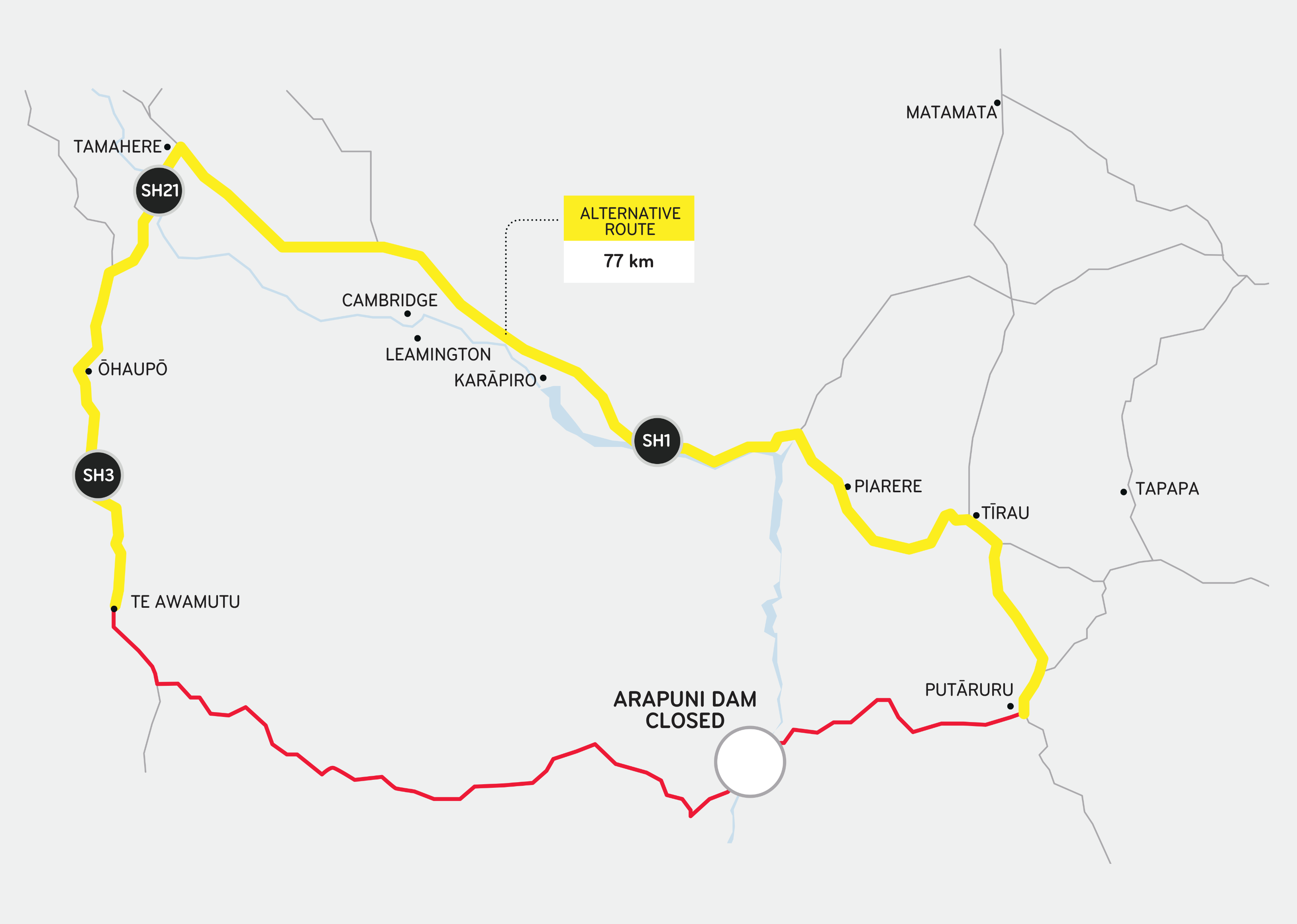

Map or heavy vehicle detour route (Arapuni Dam)

Download the alternative route for heavy vehicles (PDF)

For safety, we will close the western end of the swing bridge where it connects to Powerhouse Road.

We are making changes to Powerhouse Road so it is safe for Waikato River Trail users and safe to use as a detour route when the main works start.

Main works

We submitted a business case to our board which was approved in late 2025. We  have finalised the main works timeline and we are progressing towards the construction phase in mid-2026.

We expect construction to take 24-36 months.

Timeline

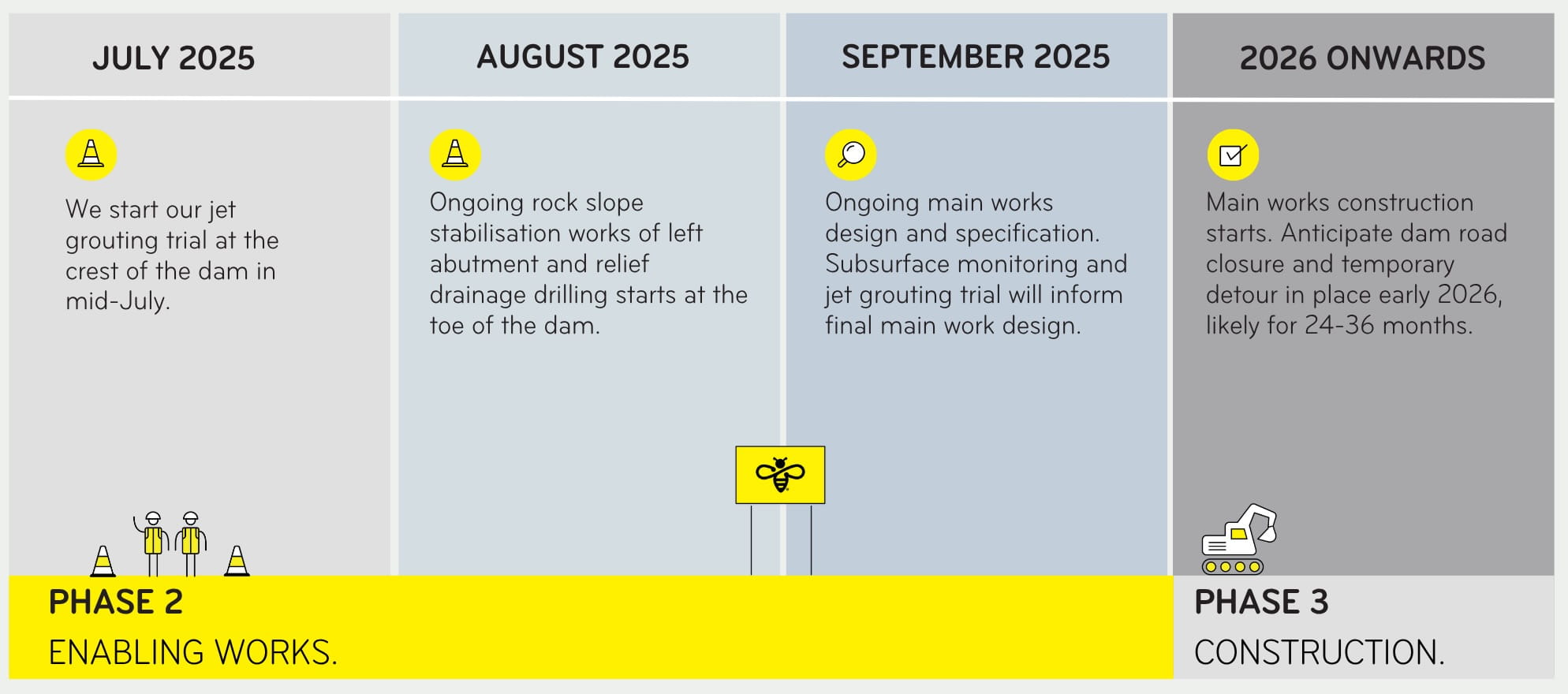

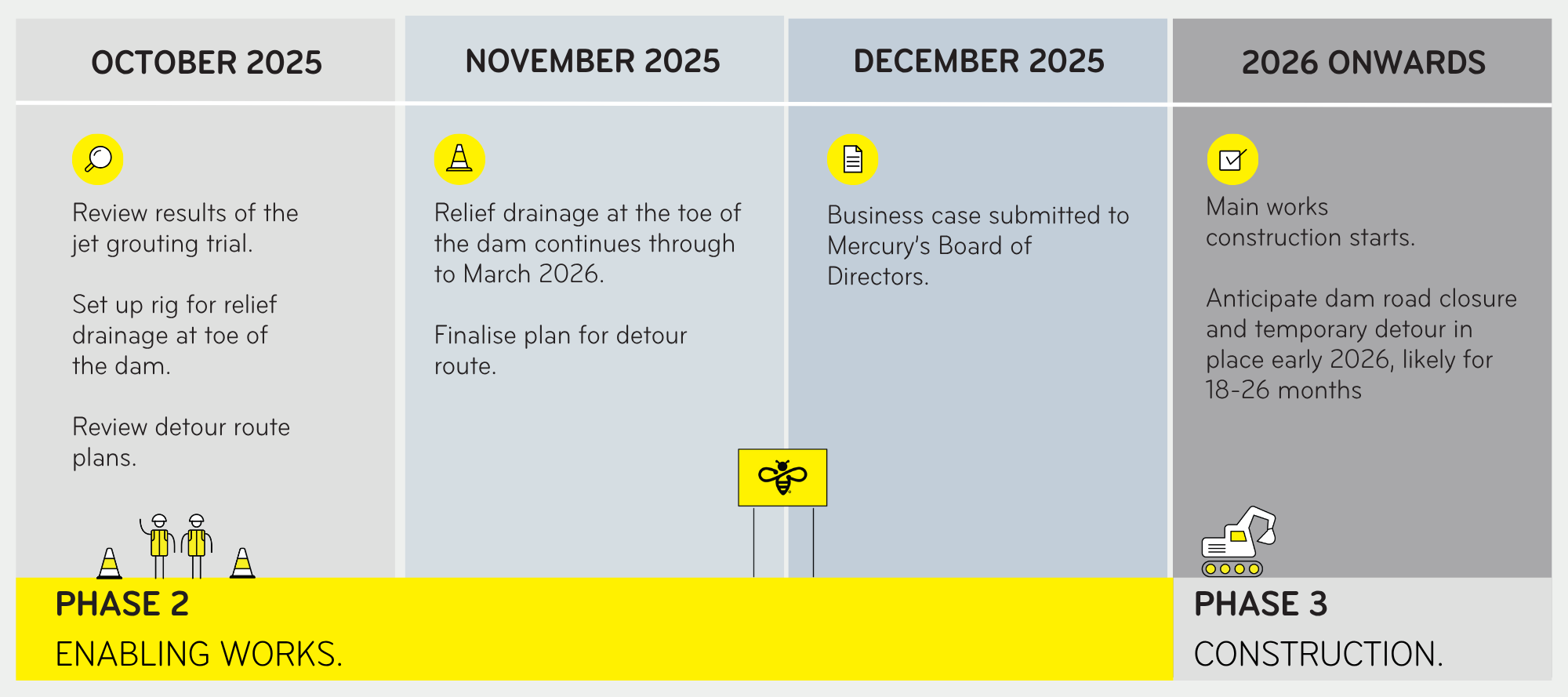

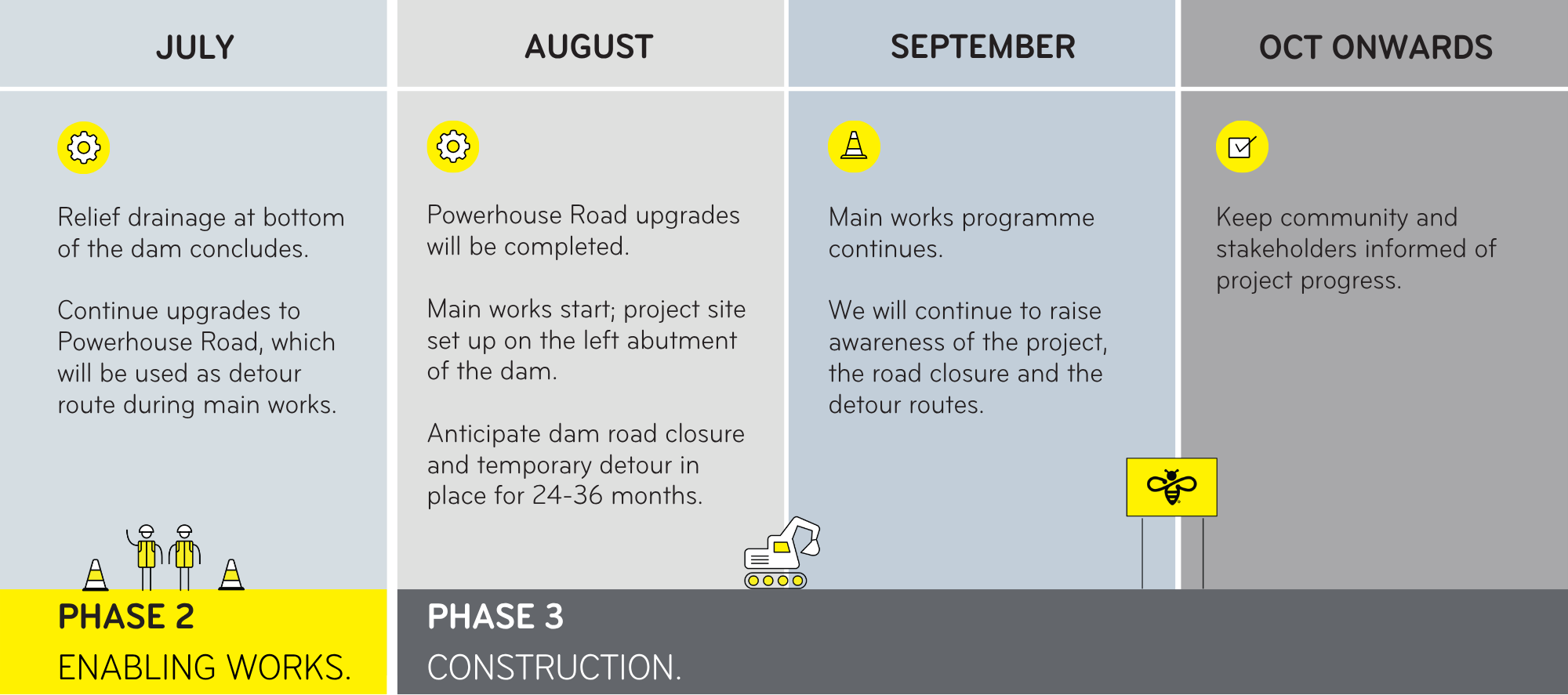

Project Timeline updated 20 March 2026

Project milestones

2026

  • In April we held our fourth community drop-in session at Rhubarb Cafe, to update people on our plans heading towards the main works phase of the project. 
  • In early March we began upgrades to Powerhouse Road, between Arapuni Road intersection and the lower bridge across the Waikato River, to prepare it for use as a temporary detour route.
  • We hosted the South Waikato District Council at the dam site and led them on a tour of the Arapuni Hydro Station, to bring them up to speed on the project.
  • We submitted a business case for the main works programme to the Mercury board.
  • In February our relief drainage work started to make good progress, on track for completion in July.
  • In January we began setting up a new work site at the bottom of the dam for our relief drainage work.

2025

  • We reset the project site in November to prepare for the start of our relief drainage work at the bottom of the dam.
  • We held our third community drop-in session at the Rhubarb Cafe on 4 October.
  • Our iwi partners from Ngāti Koroki Kahukura became involved in the management of the jet grouting trial site and environmental monitoring.
  • Rock slope stablisation work continued at the left abutment and near the track leading to the toe of the dam.
  • Members of Mercury’s Board of Directors visited the work site to learn more about the project.
  • Road and traffic experts surveyed the proposed detour route.
  • Our jet grouting trial ran from July-September at the crest of the dam.
  • We held our second drop-in session for the community at Rhubarb Cafe in April.
  • We cleared vegetation to make it easier for drivers to see each side of the dam as they enter the work site area.
  • We were taken through a cultural induction event by Ngāti Koroki Kahukura from Pōhara Marae and Maungatautari Marae to allow us to start our drilling work on the left abutment of the dam.
  • We established the first of two drilling rigs on site for relocating and installing new underground sensors.

2024

  • We began our ongoing engagement with partners, stakeholders and the wider community in mid-2024.
  • We’ve been working closely with local iwi, Raukawa and Ngāti Korokī Kahukura to better understand the impacts of the remediation work.
  • We met with Waikato Regional Council, South Waikato District Council and Waipā District Council staff and elected members to share information about the project, in September and October 2024.
  • We held a drop-in session at Rhubarb Cafe, Arapuni, to speak one-on-one with local people so they could learn more about the project, on 5 October 2024.
  • Some of our staff and contractors attended a cultural induction hui led by kaumātua at Pōhara Marae, on 16 October 2024.
  • The induction cleared the way for us to begin work on removing vegetation from the left abutment of the dam, from October-November 2024.
  • Clearing the vegetation allows us to undertake geomapping of the abutment so we can plan for relief drilling work in early 2025.

Frequently Asked Questions
